The Project Schedule

Week 1–2

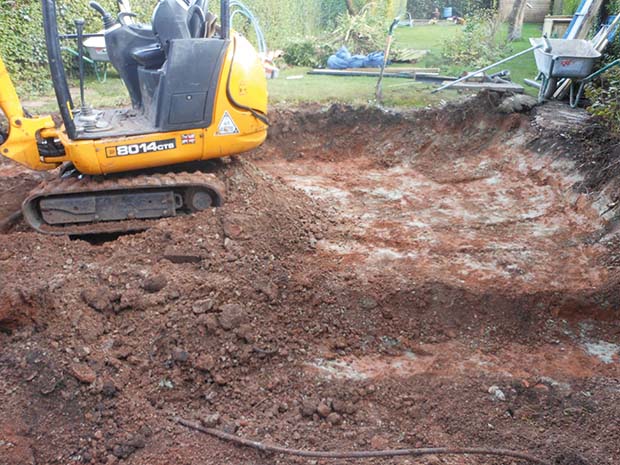

Setting out, footings dug, and foundations poured

  • Builders will arrive on site.
  • If you are project managing, you may need to arrange digger hire, but your builders should do this for you.
Setting out, footings dug, and foundations poured

Week 3–4

Building up to damp-proof course (DPC), drains installed, DPC installed and concrete oversite/floor structure put in place

  • Ensure materials are ordered and delivered ready for the concrete floors to be poured, including insulation and any damp-proof membrane.
  • In some cases, a drain run may require that a concrete lintel will need to be inserted into the brickwork at this stage.
  • Sand will then be put down before the damp-proof membrane, insulation and the concrete slab is poured.

Week 5

Building of external walls

  • It varies whether the brickwork or blocks are built first, but in both cases cavity wall insulation will be fitted at this point.
  • Wall ties are used to fix the new walls to those in the existing house.
Building of external walls

Week 6

Internal walls built

  • It’s time to begin thinking about arranging delivery of items further down the line which can be on lead times of three to five weeks (e.g. windows, roof tiles).

Week 6–7

Roof structure built

  • A carpenter will be brought in at this stage to build the roof structure. In the case of rooflights being fitted, they will also be in charge of this in most cases.
  • Ensure the roofers know when they are needed — you want to get watertight as soon as possible.
  • Check all materials are in place for the roofing, including lead.
Roof structure built

Week 7

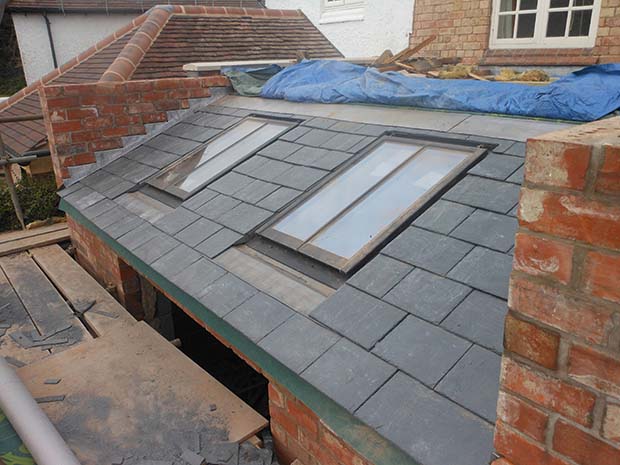

Roof Coverings

  • Roofing membrane will be laid out over the rafters before roof battens are cut and fitted over — how they are spaced will depend on your roof covering of choice.
Roof Coverings

Week 8

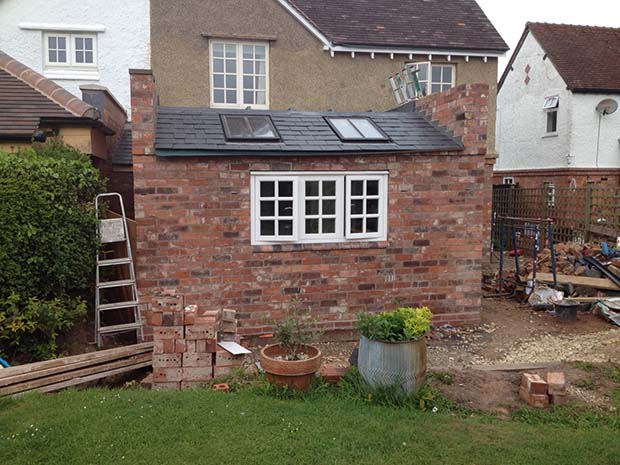

Install windows and doors

  • It is likely (and certainly preferable) that door linings and window frames will have been put in place while the external walls were built, so fitting windows and doors can now be carried out.
Install windows and doors

Week 9

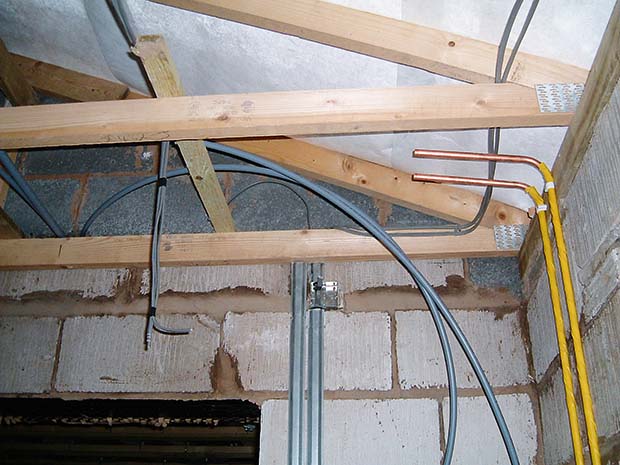

First fix electrics and plumbing; carpentry

  • Once the extension is watertight, electrics and plumbing can get underway. The two trades often have to work closely together, so ensure each knows what the other is doing to avoid delays.
First fix electrics and plumbing; carpentry

Week 10

Break through from existing house, steels put in place, joins made good

  • With the breaking through from the existing house, this is where things can get messy and, if you are still going to be living in the house, you should start sealing yourself off from the mess as much as possible.
Break through from existing house, steels put in place, joins made good

Week 11

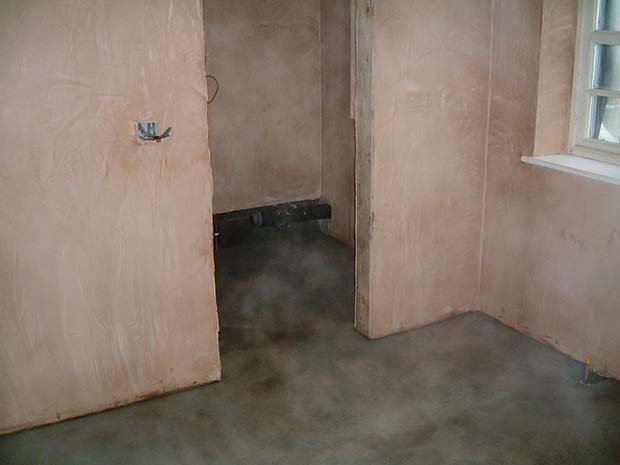

Plastering, followed by a period of drying out

  • As a general rule, new plaster should be left for around a week before any decorating takes place.
  • Be aware that plastering is a messy old job and that your plasterer will need a clear route to a water source (preferably not your bathroom…).
Plastering, followed by a period of drying out

Week 12

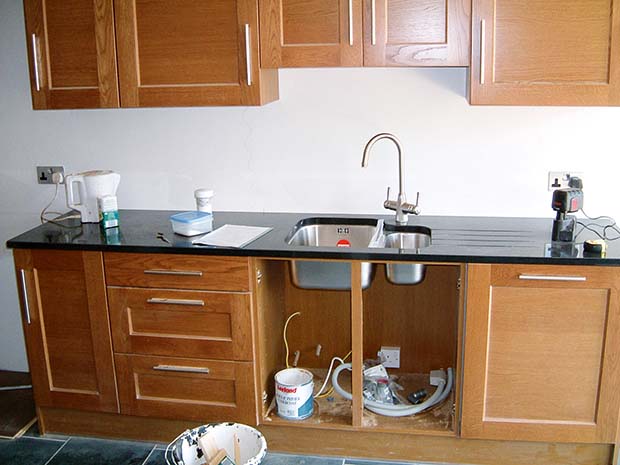

Second fix, electrics, plumbing, flooring fitted, and kitchen units installed

  • You really need to ensure all these processes can work together and that each trade knows who is doing what and when, as this is a stage when delays can occur.
Second fix, electrics, plumbing, flooring fitted, and kitchen units installed

Week 14

Snagging

  • Any leaks, problems with electrics and sticking doors and windows need to be reported to the relevant trade as soon as possible after finishing.
